Somalia's seaports and a proposed Mogadishu dry dock

Bulshadaa isu keentay · INFRASTRUCTURE · 11 min read · 2026-09-28

Waxaa isu keenay wax-ku-biiriyayaal bulsho iyagoo ka duulaya ilo dadweyne. Tirooyinku waxay noqon karaan qiyaaso — si madax-bannaan u xaqiiji ka hor inta aadan ku tiirsan.

Tusmada
  1. Summary
  2. Where Xidig members may contribute
  3. Possible services, research, supplier or collaboration roles
  4. Who may find this useful
  5. What already exists at each port
  6. Geographic context
  7. Dependencies and implementation constraints
  8. Risks and unknowns
  9. Questions members should verify before acting
  10. What is confirmed, and what isn't
  11. Relevant next steps
  12. More about the source
  13. Notes on figures
  14. Related reports
  15. About this report
  16. Sources

Who operates Somalia's ports today, which deals are already announced or disputed, where maritime skills fit, and the port and dry-dock proposals on the government's list.

Not investment advice. Independent analysis of a government publication. It takes no position on the administration of any port.

Summary

Most of the ports named in the government's proposals already have operators, concession agreements or separate development deals, made by the federal government or by member-state administrations. Some of those arrangements are publicly disputed. For members, the most solid angles are maritime skills, such as ship repair, marine engineering and cargo handling, and understanding how port concessions work.

What Xidig found:

  • Who is where. Mogadishu is operated day to day with a Turkish group, and its port authority is planning a new port about 35 km north of the city. Hobyo has a development agreement signed in October 2024, reported to run for 80 years, and South West State reportedly signed a development agreement for Barawe.
  • Some arrangements are contested. At Bosaso, the federal government announced in January 2026 the cancellation of agreements with the UAE, including at the port, and Puntland's administration said it rejected the decision, according to news reports. This report sets out both positions and does not take a side.
  • Ship repair is a gap. Xidig found no existing dry dock or ship-repair yard in Somalia.

The government has also listed three early-stage port proposals: new deep seaports at Mogadishu, Hobyo and Barawe, upgrades at Bosaso, Garacad and Kismayo (US$551.2M) and a Mogadishu dry dock (US$112.2M); details are under More about the source.

Where Xidig members may contribute

Learning and skills opportunities, not confirmed vacancies or tenders:

  • Learning: how port concessions, PPPs and revenue-sharing work, and who has authority over which port.
  • Skills: ship repair and welding, marine engineering, cargo handling and crane operation, warehouse and logistics management, and port safety and security procedures.
  • Research: comparing proposals with actual port capacity and traffic data, where operators publish it.

Possible services, research, supplier or collaboration roles

  • Ship-repair training partnerships. A dry dock would need skilled workers. The sheet itself cites "50 new jobs", and the skills would need to exist locally.
  • Freight and warehousing services at existing ports, through the current operators rather than the government's list.
  • Independent research on port performance and trade flows.

Who may find this useful

  • Maritime engineers, marine electricians, welders and fabricators.
  • Logistics, freight-forwarding and customs professionals.
  • Lawyers and economists interested in concessions.
  • Students in maritime studies.
  • Traders who import or export through these ports.

What already exists at each port

The table below summarises public reporting found by Xidig. Confidence varies; "reported" means news coverage not confirmed by an official document.

PortWhat exists or is agreed (latest found)SourceConfidence
MogadishuOperated day to day with Turkey's Albayrak Group through Mogadishu Alport, under a 2014 agreement ("the right to operate of the port for 20 years"). A new 14-year concession was reported in 2020. The Mogadishu Port Authority says it "is planning a new, state-of-the-art port facility approximately 35 km north of Mogadishu". In late 2025 the ports minister said construction would start in 2026. Reports from late July 2026 describe plans and upgrades to the existing port; Xidig found no report that construction had begun.Albayrak; Daily Sabah (2020); Mogadishu Port Authority (Sep 2026); TRT Afrika (late 2025); Dawan and Capmad (29 Jul 2026)Confirmed (operator, plan); reported (2020 terms, 2026 start not confirmed)
HobyoAn 80-year agreement between the Hobyo Investment Company and Turkey's Metag Holding, signed in Mogadishu in October 2024 with Galmudug's president present. Reported initial budget of "$70m for its first phase". The Somali Ports Authority lists Hobyo as "Coming Soon".SONNA (7 Oct 2024); The Star; The Africa Report; SPAConfirmed (signing); reported (terms)
BaraweSouth West State reportedly signed a development agreement with Kuwait's Arabi Holding Group, described as a US$500M deal.FTL Somalia (19 Feb 2025)Reported; terms unverified
BosasoDP World's subsidiary P&O Ports signed a 30-year concession in 2017. P&O left in 2019 and DP World returned in July 2022, with a reported US$366M expansion. In January 2026 the federal government announced the cancellation of agreements with the UAE, including at Bosaso. Puntland's administration said it rejected the decision. In July 2026, Puntland traders and DP World were reported to have settled a separate dispute at the port. Xidig has not confirmed the concession's current status.Garowe Online (2024); The Conversation (2022); SPA; Middle East Eye (12 Jan 2026); Dawan (19 Jul 2026)Confirmed (concession); reported (cancellation dispute)
GaracadInaugurated on 22 October 2022, and described by the Somali Ports Authority as "developed through a Somali private-sector-led investment model". Expansion and a new cargo storage facility were reported in August 2026.Hiiraan (2022); SPA; Kaab TV (Aug 2026)Confirmed (opening); reported (expansion)
KismayoKismayo Port Company describes itself as "a joint venture with the government of Jubaland" operating "under a concession agreement".KPC websiteSelf-described; partner and terms not verified
Dry dockXidig found no existing dry dock or ship-repair yard in Somalia, and no announced dry-dock plan beyond the government's proposal.—Not found

What this means for the proposals. The booklet presents these ports as investment opportunities without referring to any of these arrangements. The deep-seaport sheet for Mogadishu may relate to the port authority's plan for a new port north of the city, but the booklet doesn't say so. At Hobyo and Barawe, separate agreements have already been announced. At Bosaso and Kismayo, existing concessions and member-state administrations are central. At Bosaso, the federal government and Puntland have taken different public positions; this report sets out both as reported and does not take a side.

Geographic context

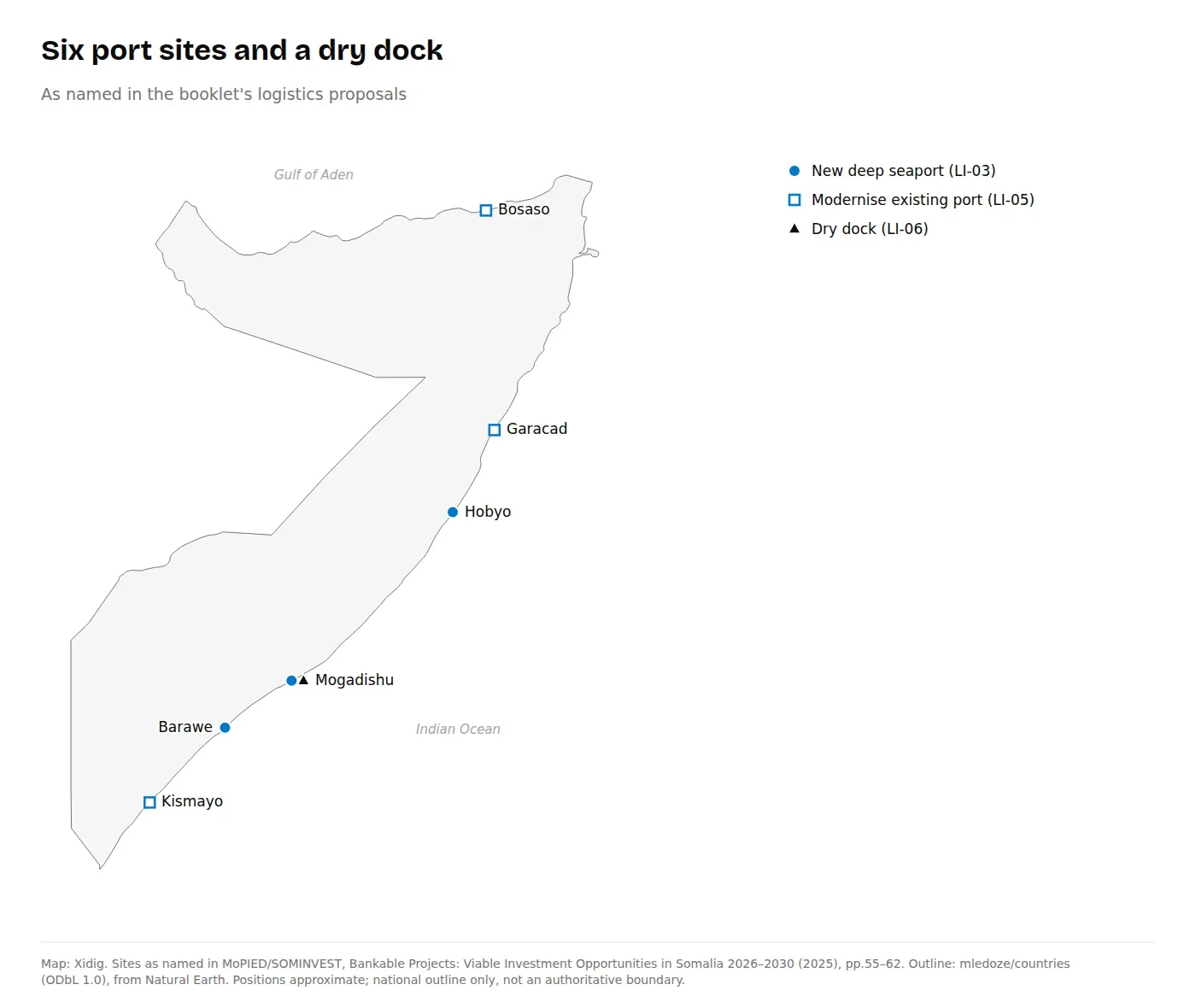

Port sites named in three proposals. Existing operators and administrations at several of these ports are not mentioned in the proposals.

The six sites run the length of the coast. Bosaso is on the Gulf of Aden; the other five are on the Indian Ocean. Five are in areas administered by member states: Bosaso and Garacad (Puntland), Hobyo (Galmudug), Barawe (South West State) and Kismayo (Jubaland). Mogadishu is under the Banadir Regional Administration and federal institutions.

Dependencies and implementation constraints

  • Existing concessions and operators would have to be part of any upgrade, or at least consulted.
  • Federal and member-state authority over ports is not addressed in the proposals.
  • Hinterland roads: the deep-seaport sheet cites a "Road link" and "strategic hinterland road corridor". See Somalia's roads and trade corridors.
  • Dredging, breakwaters and berths for deep-water ports are costly and technically demanding. No feasibility study is cited.
  • Skills for a dry dock are scarce locally, which the dry-dock proposal itself implies by citing reliance on Dubai and Mombasa.

Risks and unknowns

  • Cost notation: the deep-seaport cost is printed as "$ 1,008.3 B"¹.
  • Overlap with announced deals at Hobyo and Barawe, and with Mogadishu's new-port plan.
  • Disputes: the federal government and Puntland have taken different positions on the Bosaso arrangements (2026).
  • Job figures (9,000 direct and 12,000 indirect; 2,000; 50) are unsourced.
  • "Greenfield" tick on a modernisation proposal.

Questions members should verify before acting

  1. Which authority is responsible for each port today: federal ports ministry, port authority, member state or concessionaire?
  2. Is the proposed Mogadishu deep seaport the same as the port authority's planned new port north of the city?
  3. How do the Hobyo and Barawe proposals relate to the agreements already announced there?
  4. What figure is intended by "$ 1,008.3 B" (note 1)?
  5. Is there a current procurement notice, and from which authority?

What is confirmed, and what isn't

Confirmed

  • The three proposals, printed costs, sites and pre-feasibility status.
  • Albayrak's role at Mogadishu.
  • DP World's Bosaso concession (2017).
  • Garacad's opening (Oct 2022).
  • The Hobyo signing (Oct 2024).
  • The Mogadishu Port Authority's new-port plan.

Our interpretation

  • The government's port proposals overlap with arrangements they do not mention.
  • Maritime skills are the most durable member angle.

Not yet verified

  • Terms of the Hobyo, Barawe and Kismayo arrangements.
  • The 2020 Mogadishu concession terms.
  • The outcome of the January 2026 cancellation announcement.
  • All job figures.
  • Any dry-dock plan beyond the government's proposal.

Relevant next steps

  • Follow the Somali Ports Authority and Mogadishu Port Authority sites for official notices.
  • Maritime professionals: map ship-repair skills and training routes in the region.
  • Share first-hand port knowledge through Xidig, with care: avoid sharing commercially sensitive or security-sensitive information.

More about the source

The government's investment booklet, Bankable Projects 2026–2030 (MoPIED / SOMINVEST), is one of the sources for this report. The details it gives are summarised here as printed.

Construction of New Deep Seaports (LI-03, pp.55–56).

  • What: "Development of three new deep seaports in Mogadishu, Hobyo, and Barawe with modern mechanization, handling, and storage capacity." It "will position Somalia as a major regional trading hub".
  • Key drivers: "Create 9,000 direct and 12,000 indirect jobs" and "Reduce congestion at existing Mogadishu port".
  • Estimates: cost printed "$ 1,008.3 B"¹; 5 years.
  • Ticks: Brownfield, Greenfield and Expansion, with PPP.

Modernisation of Existing Ports (LI-05, pp.59–60).

  • What: "Upgrading existing ports in Bosaso, Gara'ad, and Kismayo with modern mechanization, new berths, warehousing, & enhanced cargo handling capacity."
  • Key drivers: "Create 2,000 direct jobs."
  • Estimates: US$551.2M; 5 years.
  • Ticks: "Greenfield", which is unusual for existing ports.

Construction of Dry Dock at Mogadishu (LI-06, pp.61–62).

  • What: a dry dock "to provide ship repair, maintenance, and marine services", "reducing reliance on Dubai and Mombasa".
  • Key drivers: "Create 50 new jobs."
  • Estimates: US$112.2M; 5 years.

Estimated costs as printed. The deep-seaport cost is not shown because its printed notation needs confirmation (note 1).

  • Primary source: MoPIED / SOMINVEST, Bankable Projects 2026–2030, posted 19 Nov 2025. Logistics & infrastructure section, PDF pp.55–62.
  • Promoters: SOMINVEST and the Ministry of Public Works, Reconstruction and Housing. The booklet does not name the Ministry of Ports and Marine Transport or the ports authorities.
  • Status: pre-feasibility on all three sheets.

Notes on figures

¹ Printed as "$ 1,008.3 B" (PDF p.55). The booklet gives its other costs in millions ("M"), for example "$551.2 M" for port modernisation on p.59. Read literally, this figure would be more than a thousand billion US dollars, larger than all the booklet's other proposals combined. It is therefore most likely a formatting error, possibly for US$1.008 billion. Xidig has not changed the figure; it should be confirmed with the Ministry of Public Works, Reconstruction and Housing. Please check the source before relying on it.

  • Somalia's Bankable Projects 2026–2030, explained
  • Somalia's fisheries: vessels, processing and landing sites
  • Somalia's roads and trade corridors
  • Bosaso: port, power, fish and livestock trade
  • Garacad: the port Somali investors built
  • Hobyo's port plans and the road inland
  • Kismayo's port, power, water and fish trade
  • Mogadishu's new airport, port and other planned projects
  • Ship repair in Somalia: the skills a dry dock would need

About this report

By Xidig members and collaborators.

Project codes. Codes such as EN-04 or AG-05 are Xidig's own shorthand for the booklet's fact sheets, by sector; the booklet itself does not number its projects.

How we researched it. We read the full 97-page booklet and checked every figure, page reference and quotation used here against it. We then compared the booklet's claims with the official, international and news sources listed below, and we say where they differ. We did not interview anyone for this report. Where the booklet's figures are unclear, we reproduce them as printed and explain the issue in the notes.

Corrections. If you spot an error, please tell us using the correction link on this page.
